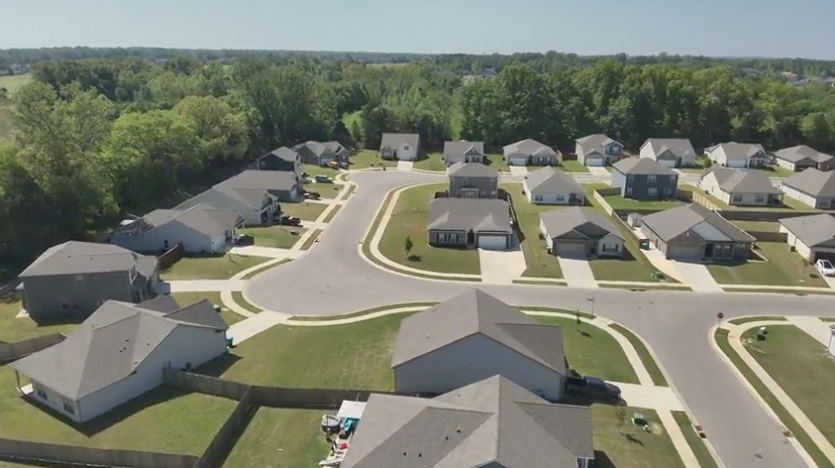

Village Park Phases 1 & 2

Village Park Phases 1 & 2 are a single-family residential subdivision in Oakland, Tennessee. These phases total 83 residential lots. This project was developed and constructed in-house.
Project Scope
- Land acquisition
- Entitlements
- Engineering, phase planning, lot & layout configuration
- Environmental permitting
- Municipal approval and recording
- Geotechnical reports
- Utility easements and planning for undergound facilities
- Public street dedication and right-of-way planning
- Civil Construction
- Clearing, excavation, and grubbing
- Fine grading
- Soil cement and asphalt
- Curb, sidewalks, and drive aprons
- Mail kiosk
- Erosion control
- Sanitary sewer (including pump station)
- Drainage systems
- Public water
Project Characteristics

- Zoning
- R-2SF
- Acreage
- Buildable space - 25.157 acres
- Common open space - 0.564 acres
- Lot sizes
- Standard lots - 8,400 to 9,300 square feet (120 feet deep)
- Corner/cove lots - 10,000 to 17,700 square feet (varied depth)
- Setbacks
- Front yard - 30 feet
- Side yard - 7.5 feet
- Rear yard - 20 feet

Project execution
Construction for phase 1 took place between July 2020 and August 2021. Construction for phase 2 took place between November 2021 and May 2022.
Both phases were delivered as a fully platted, pad-ready residential subdivision to D.R. Horton. Visit their webpage at https://www.drhorton.com/tennessee/memphis/oakland/village-park for home availability.
SHAPING COMMUNITIES FROM THE GROUND UP.
Whether you’re planning a civil project, land development, or community subdivision, Pro-Site Construction and PFMT Holdings have the expertise and execution capability to get the job done right.
.png)
